American Edge Engineers
6 / 73

NSV Industrial Shed & Office, Chakan

Service: MEP Design & Engineering

Chakan, Pune, MaharashtraIndustrial / Manufacturing

  • Load Demand
  • Transformer & Diesel Set Sizing
  • Fire Protection (Sprinklers, Hydrants, Water Curtain)
  • Fire Pump Schematic
  • Water Demand & Sewage Treatment
  • Storm Drainage
  • Office Electrical Layout
  • Slab Sleeve & Cutout Coordination

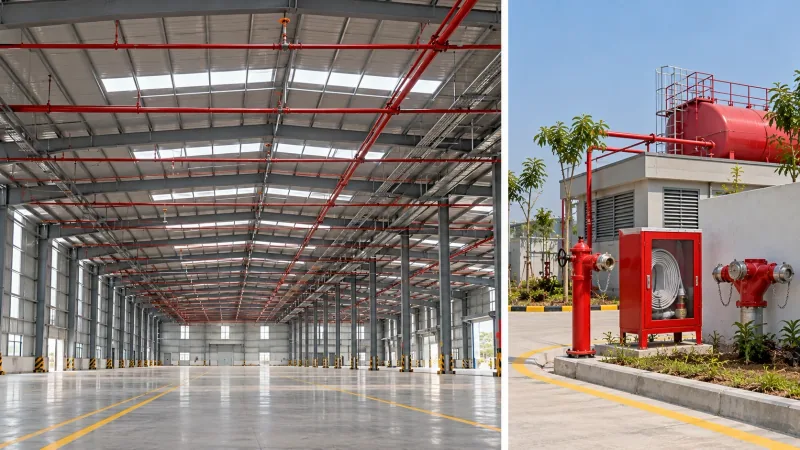

Industrial shed protected by sprinklers, hydrants and a water curtain
157 x 56m
Connected load for the campus, 405 kW after diversity
466kW
Transformer, with a 625 kVA diesel set for standby
630kVA
Capacity of each of the four main fire pumps
2,850lpm
Water for 1,000 users, with a 45 KLD sewage plant
45kL a day
Shed lights and fans: 623 high bays and 700 fans over 8,811 sq m
98.9kW

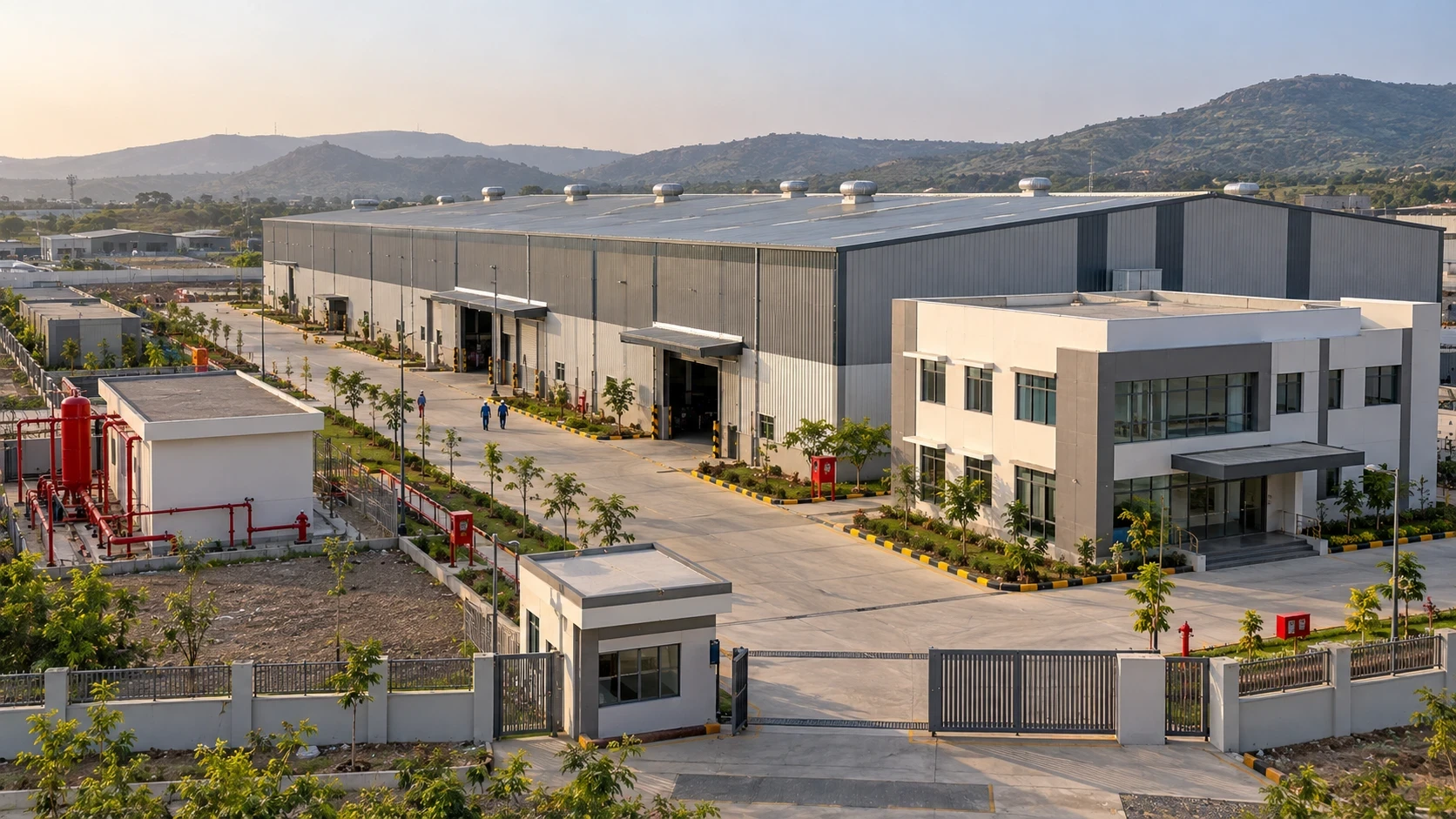

Illustrative render of a large industrial shed and a two-storey office building at Chakan, with a fire pump house and tank, hydrants, a gated entrance and a security cabin, and green hills behind
Illustrative image

Project information

An industrial campus at Chakan, Pune's automobile and engineering belt, on a plot beside a 24 m road: a single-storey shed of about 157 x 56 m (roughly 8,700 m² under one roof), a two-storey office building of about 11 x 25 m, a canteen, toilets, a transformer and a DG set, with a 6 m fire drive way around the buildings. A shed of this size is a fire-engineering problem before it is anything else. It is a wide, open volume with a high roof, so a fire can spread across a large area quickly; fire-fighters need water on every side of it; and the walls themselves need protection. The architect's layout and plinth levels set the structure; our work is the fire-fighting system that protects it, and the electrical and slab services of the office building. For the whole campus we also worked out the numbers that decide what is built: the electrical load, the water demand and the sewage and storm drainage.

Gallery

Illustrative renders of the building and its setting, not photographs of the finished site. Select an image to enlarge it.

How We Helped NSV Industrial Shed & Office, Chakan

We designed the fire protection from the water source to the last sprinkler. Pumping: a fire schematic with a sprinkler pump, a hydrant pump, a standby pump, a water curtain pump, each of 2,850 lpm, and a 180 lpm jockey pump that holds the system under pressure, with Y-strainers, non-return and butterfly valves, foot valves, rubber bellows, pressure gauges and flow switches drawn in the order they are met on the pipe. Sprinklers: upright quick-response K-80 sprinklers rated at 68 °C throughout the shed, on branches of 25, 32, 40, 50 and 65 mm galvanised C-class pipe fed from 150 mm headers, with flow switches and valves to isolate zones. Hydrants: a 150 mm hydrant main around the shed along the 6 m fire drive way, single-headed hydrants with 63 mm instantaneous outlets to IS 5290, hose boxes with 15 m hoses and key boxes, and the stand-pipes and 150 mm butterfly valves that serve them, issued as an external fire layout and revised after a site visit. Water curtain: a 150 mm water-curtain pipe with nozzles and a deluge valve along the shed walls, on its own pump so it does not take water from the sprinklers. Fire-brigade access: 2-way draw-out, 3-way and 4-way fire-brigade inlets and hydrant valves, positioned for the engines on the drive way. Extinguishers: 15 of 6 kg ABC and 4.5 kg CO2 units placed to IS 15683, with the CO2 types for electrical areas. Office building: the ground-floor electrical fixture and conduit layout with 25 mm concealed PVC conduits, switch boards, a power distribution board with MCB and RCCB, fan points with step regulators, exhaust fans, air-conditioner points with power, control wiring and drain coordination, and separate conduits for TV, data and telephone; and a first-slab MEP layout with 200 mm sunk slabs for the toilets, an 800 x 150 mm electrical and low-voltage cutout through the slab and the staircase set out, all marked before the concrete was cast. The set was issued in March, May and August 2026. Calculations (January to April 2026): the electrical load built up from the shed's 623 high-bay lights and 700 fans, the offices, air conditioning, pumps and the production machinery - 466 kW connected and 405 kW of maximum demand, which sets a 630 kVA transformer and a 625 kVA diesel set, with a 15 kVA UPS for the office; water demand of 45 kL a day for 1,000 users, with 110 kL of underground and 25 kL of overhead storage and a 45 KLD sewage plant that returns 15 kL a day to flushing; a 17 kL basement sump sized from 30 sprinklers discharging for ten minutes; and a storm drain of 17 catch basins and 122 m of pipe.

The brief

What the project needed, and how we answered

  1. 01

    Put out a fire in a shed bigger than a football pitch.

    Quick-response upright sprinklers rated at 68 °C across the whole roof, on 25 to 65 mm branches from 150 mm headers, with flow switches to show which zone has operated and valves to isolate a zone without shutting the system.

  2. 02

    Give fire-fighters water on every side.

    A 150 mm hydrant main with single-headed hydrants and 63 mm outlets to IS 5290, glass-fronted hose boxes with 15 m hoses, and 2-way, 3-way and 4-way fire-brigade inlets, all reachable from the 6 m fire drive way.

  3. 03

    Keep fire off the shed walls.

    A water curtain of 150 mm pipe and nozzles with a deluge valve along the shed walls, supplied by its own 2,850 lpm pump so the sprinklers keep their water.

  4. 04

    Keep the pumps ready without running.

    Four main pumps of 2,850 lpm (sprinkler, hydrant, standby and water curtain) with a 180 lpm jockey pump, and Y-strainers, non-return valves, foot valves, bellows and gauges laid out in the fire schematic.

  5. 05

    Size the power supply for a plant that runs all day.

    The load was built up from the machinery (240 kW), the shed's lights and fans, air conditioning, pumps and offices: 466 kW connected, 405 kW after diversity. That sets a 630 kVA transformer with a 20% margin.

  6. 06

    Keep production and the office running in a power cut.

    A 625 kVA diesel set sized at 80% of the connected load plus a 20% margin, and a 15 kVA UPS with 15 minutes of backup for the office lighting, computers and audio-visual system.

  7. 07

    Water and drainage for 1,000 people.

    45 kL a day, stored in 110 kL underground and 25 kL overhead tanks, treated in a 45 KLD plant that returns 15 kL a day to flushing, with a storm drain of 17 catch basins taking rain away.

  8. 08

    An office that is built right the first time.

    Concealed 25 mm PVC conduits with 15 mm gaps in the slab, points marked before the pour, 200 mm sunk toilet slabs and an 800 x 150 mm electrical and low-voltage cutout, all on one slab layout.

System by system

What we designed, with the numbers

How the electrical load was built up, and the transformer, diesel set and UPS it sets.

Shed lighting and fans
623 LED high bays of 80 W and 700 fans of 70 W over 94,844 sq ft (8,811 sq m): 98.9 kW; the lighting alone is 5.7 W per sq m
Office lighting
18 W LED ceiling lights: 45 on the ground floor and 89 on each upper floor, with fans, toilets and staircases
Power points
16.5 kW: 11.6 kW in the shed, about 1.6 kW on each office floor
Air conditioning
44.8 kW for about 64.6 tons of cooling at 150 sq ft a ton, in four zones
Pumps
Landscape 2 HP, sewage plant 10 HP, domestic water 5 HP, with the fire pump allowance
Machinery
240 kW of production machinery on the client's list, counted in full
Totals
465.6 kW connected; 405.4 kW maximum demand
Transformer
465.6 kW / 0.9 = 517 kVA; with a 20% margin 621 kVA; a 630 kVA transformer (at demand alone it carries 450 kVA)
Diesel set
465.6 kW x 0.8 diversity = 372 kW; 466 kVA at 0.8 power factor; 560 kVA with a 20% margin; a 625 kVA set
UPS
13.8 kW of lighting, computers and audio-visual at 80% = 11.1 kW; 15 kVA with 15 minutes of backup
Landscape lighting
1.17 kW: 20 wall lights, 30 bollards, 6 up-and-down lighters and 10 underwater lights

Deliverables

The calculations behind the design

The numbers that size the supply, the water and the drains, issued before the drawings.

  • 466kW connected

    Load demand

    Lights, fans, power points, air conditioning, pumps and machinery, with transformer, diesel set and UPS sizing (January 2026).

  • 45kL a day

    Water demand & sewage

    Demand, 110 kL underground and 25 kL overhead storage, and a 45 KLD plant (January 2026).

  • 17kL

    Basement sump

    From 30 sprinklers discharging 56.6 lpm each for ten minutes.

  • 122m of pipe

    Storm drainage

    17 catch basins, 200 and 250 mm pipe at 1 in 200 (April 2026).

  • 4main pumps

    Fire schematic

    Sprinkler, hydrant, standby and water-curtain pumps of 2,850 lpm, with a jockey pump.

Engineering data

Where the 466 kilowatts goes

The load was built up from the shed floor to the office, then the diversity factors were applied. More than half of it is the production machinery the client supplied; the shed's lights and fans are next.

Connected load

465.6 kW

Everything running, before diversity

  • Production machinery24052%
  • Shed lights & fans98.921%
  • Pumps, incl. fire46.310%
  • Air conditioning44.810%
  • Power points16.54%
  • Offices, outdoor, AV & misc.19.14%

Share of 465.6 kW

Maximum demand

405.4 kW

After diversity: what the supply serves

  • Production machinery24059%
  • Shed lights & fans8922%
  • Air conditioning35.99%
  • Pumps in normal use12.73%
  • Power points9.92%
  • Offices, outdoor, AV & misc.184%

Share of 405.5 kW

Transformer
630 kVA
Diesel set
625 kVA
UPS
15 kVA, 15 min
Water
45 kL a day

623 high-bay lights of 80 W use only 5.7 W per sq m of the 8,811 sq m floor. The 700 fans use as much again, 49 kW, which is why the shed's fans, not its lights, are the part to look at when the bill comes in.
